Within Teamwork, you can make a copy of an existing project on your site and customize which project items to include.

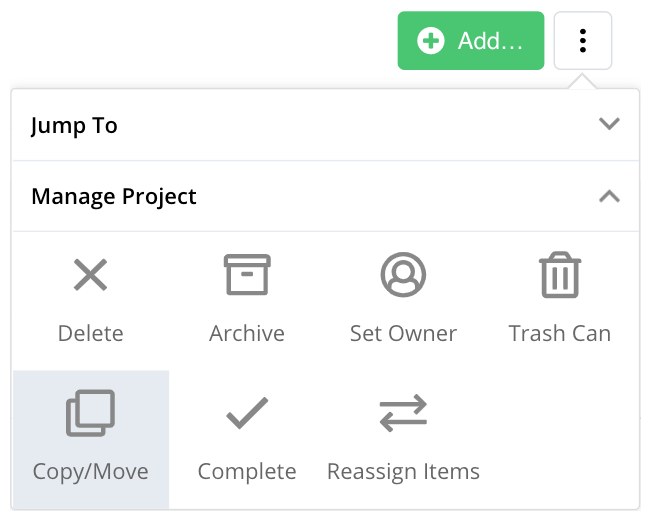

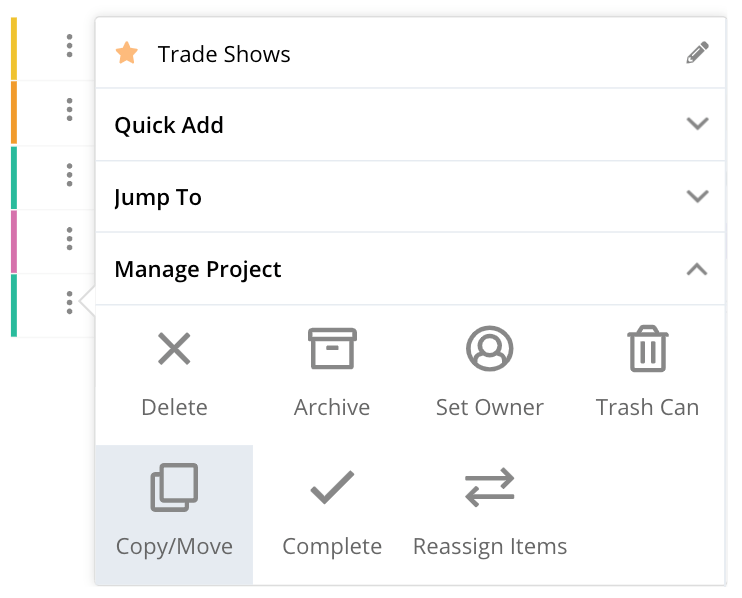

Hover beside the project name to reveal the options button. Click the three dots and select the Copy option within the Manage Project section.

Image Placeholder

You can also find the copy option whenever you are viewing a list of projects.

Image Placeholder

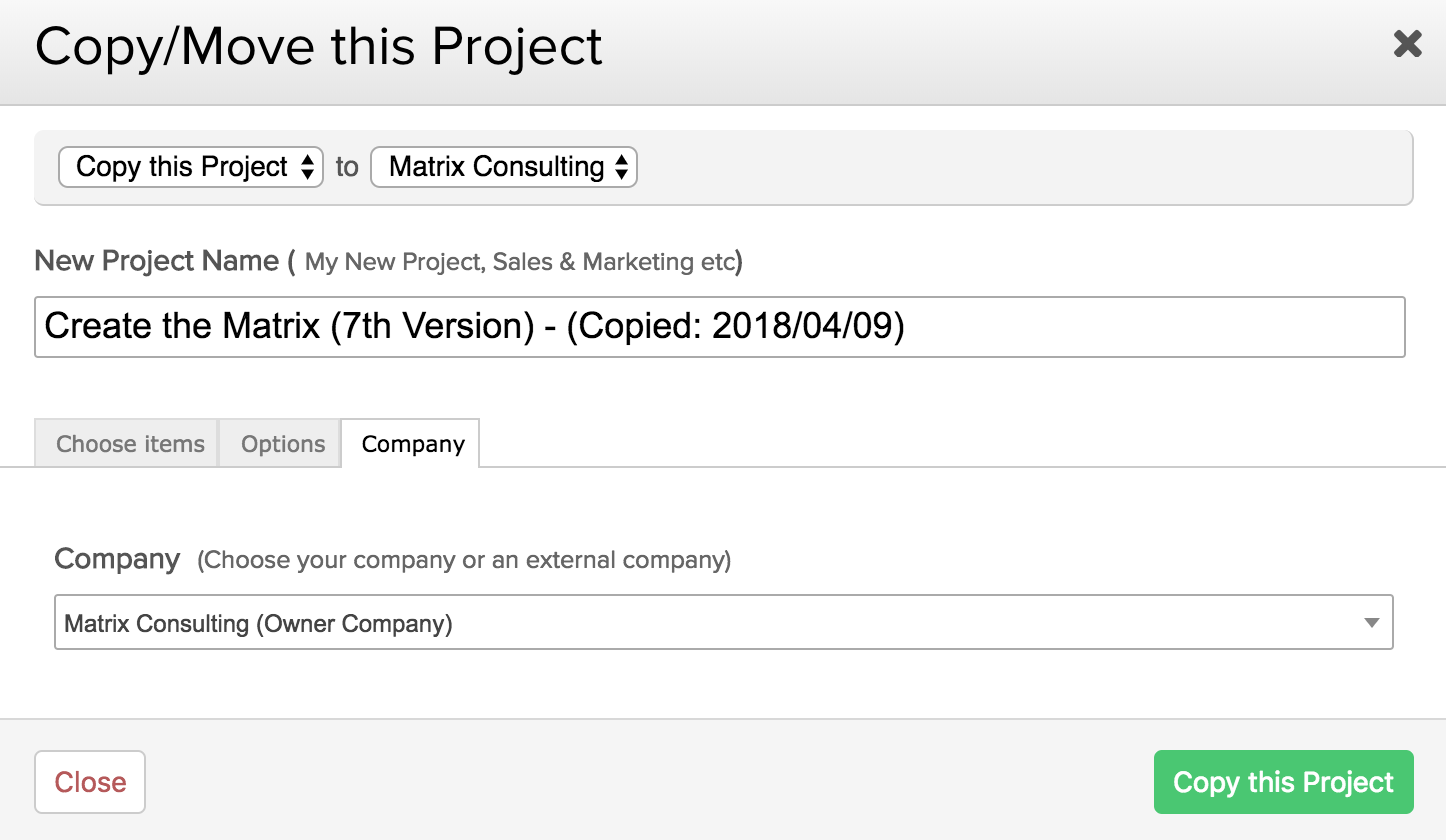

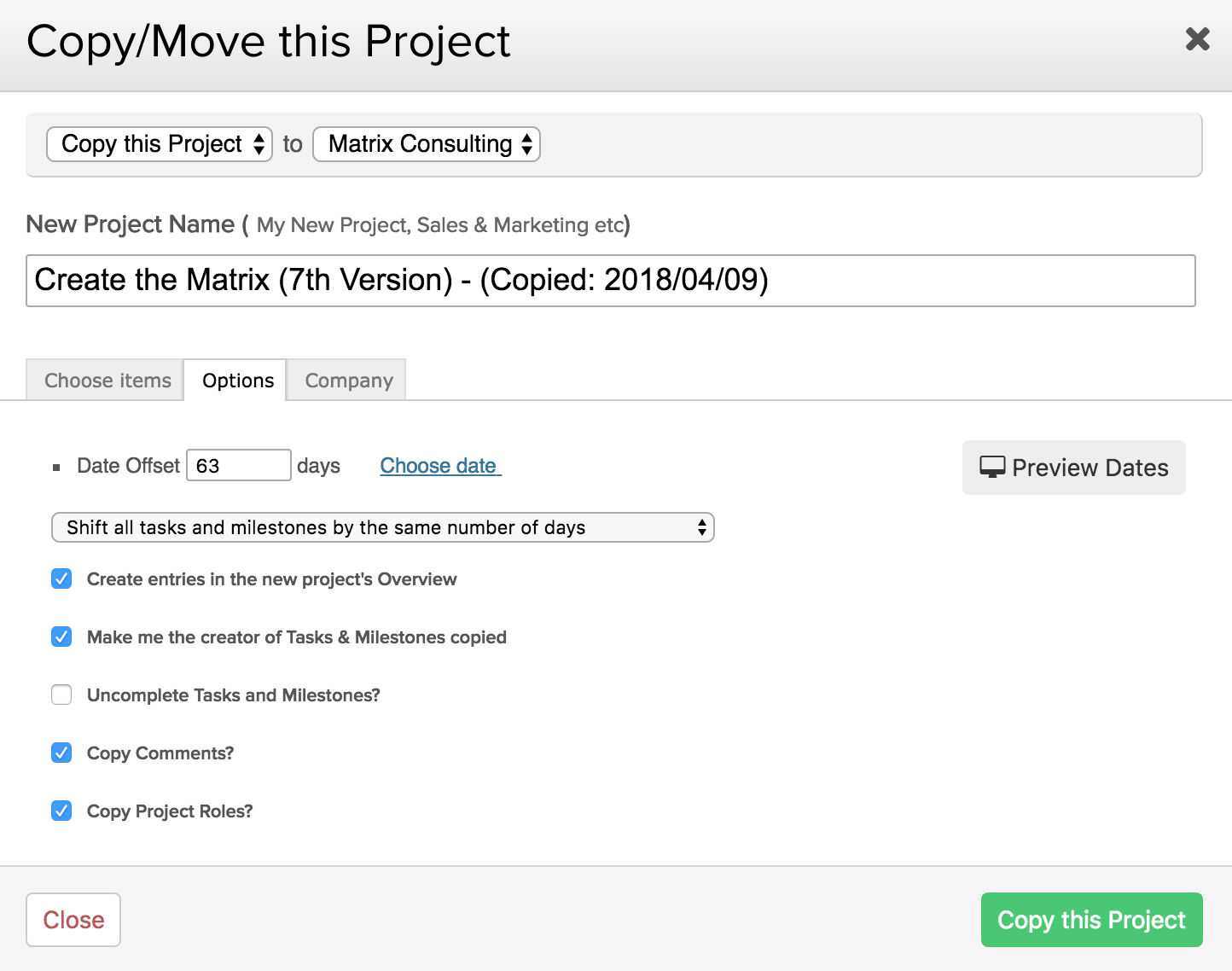

When you choose Copy, you will see all of the options available.

If you have set up a link to other sites in your profile and you are a site administrator on both, you can choose to copy the project to that site or make a copy in the current site.

Note: The option to move a project will only be shown if your site has been linked to another Teamwork site.

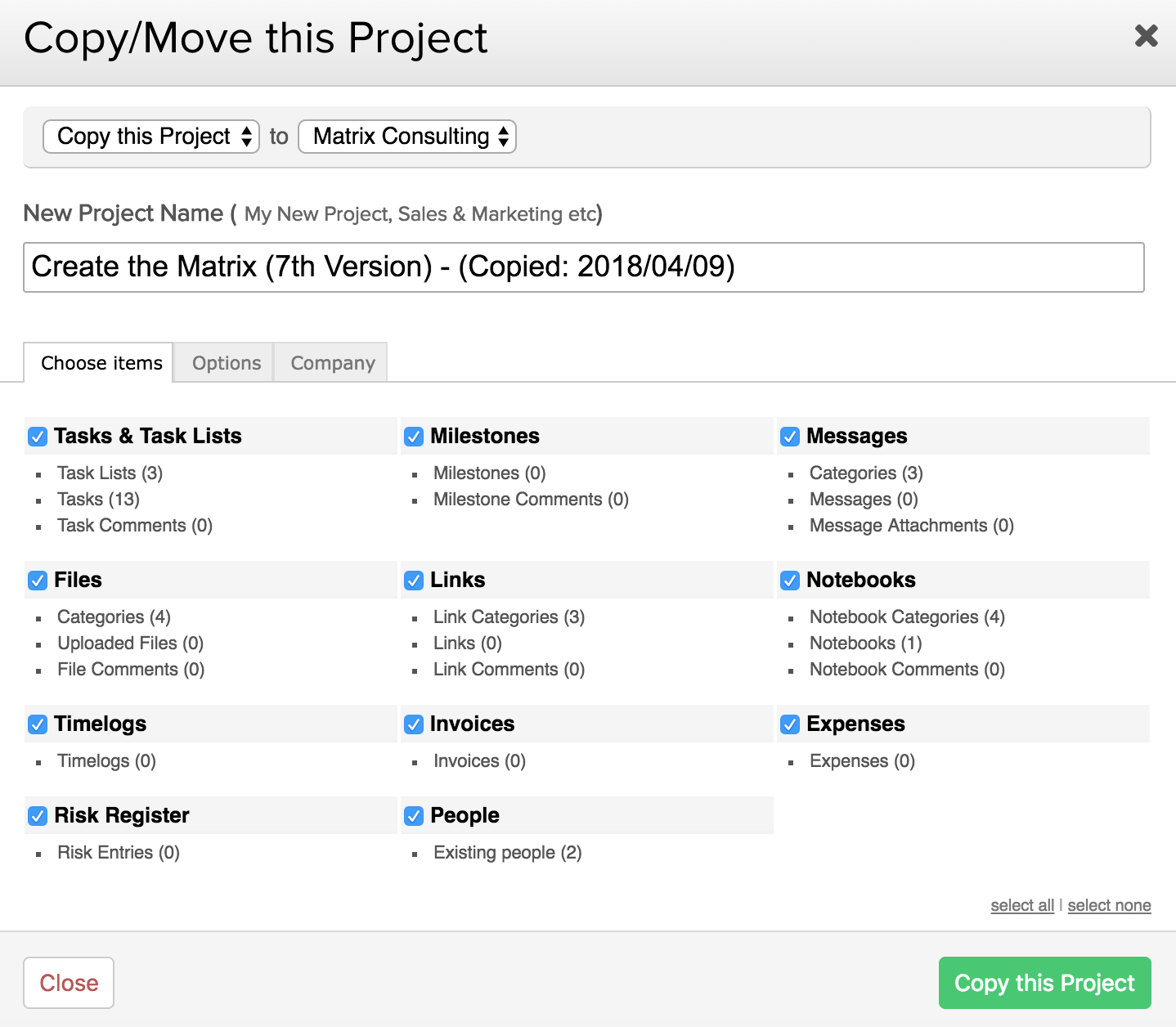

Choose items

In the choose items tab, you can add a name for the copy of the project, and choose which content to copy by selecting the checkboxes next to each content type.

Note: The copy project modal retains your choose items preferences from the previous time a project was copied.

You will see the total number of items in the original project next to each one.

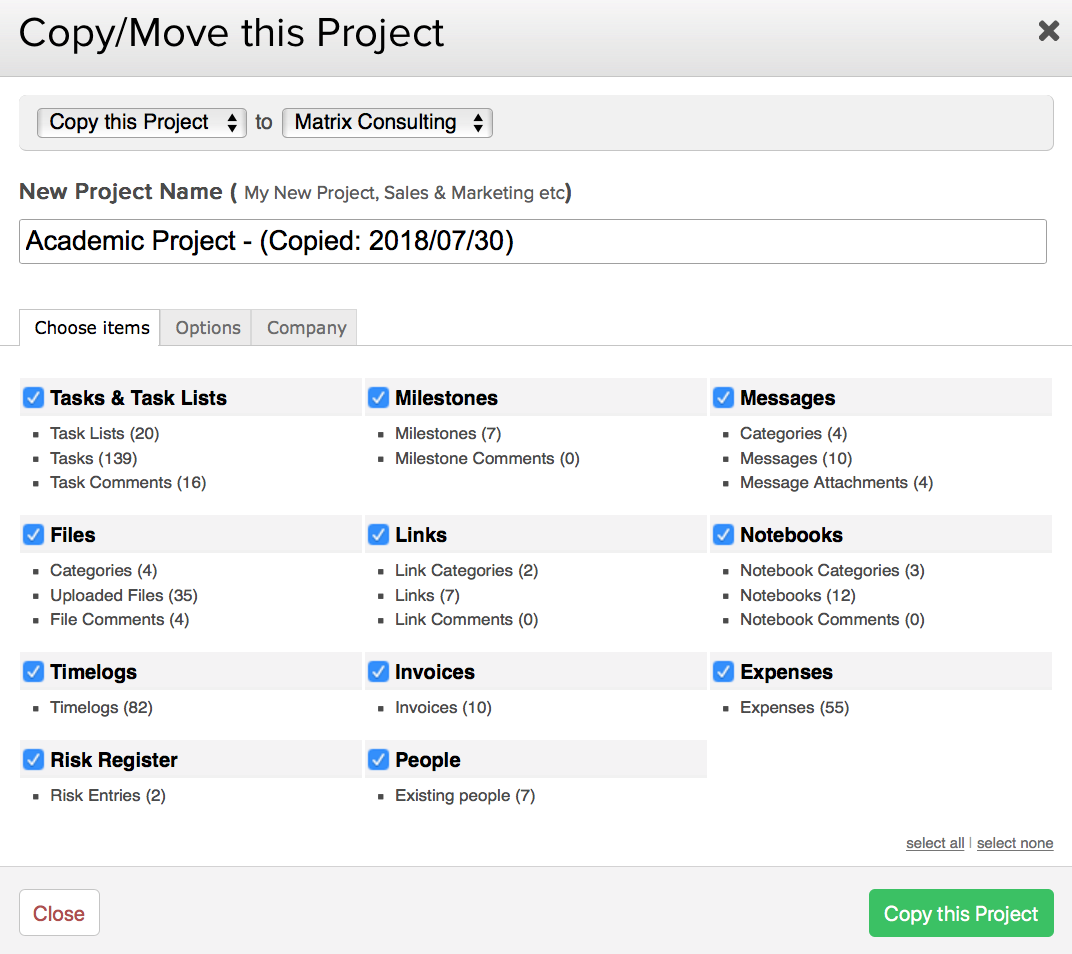

Image Placeholder

Note: Only the first instance of a repeating task will be copied when copying a project. Any other tasks in the series will not be copied.

Options

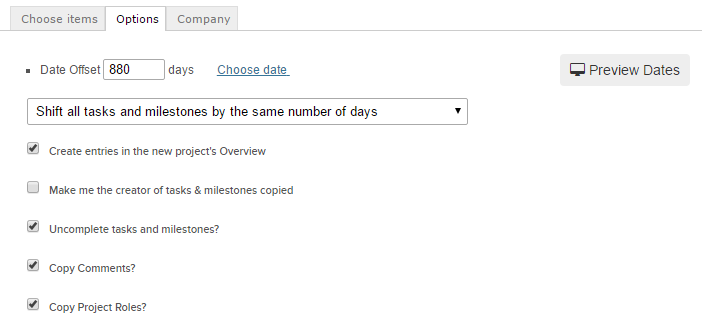

In the options tab, you can choose how the dates from the original project will be set up in the new copy.

If your original project has a start date, that will be taken as day 0, otherwise the date that the project was created will be used.

The new dates can be calculated with the following options:

  • Shift all tasks and milestones by the same number of days
  • Don't include Saturdays and Sundays when calculating new dates
  • Calculate new due dates but keep tasks and milestones off weekends
You can use the date preview option to see the effect of any settings chosen here, before making the copy.

The other options allow you to control whether other elements from the original project are copied, including activity updates, task and milestone creator, comments, follower, project roles and project updates.

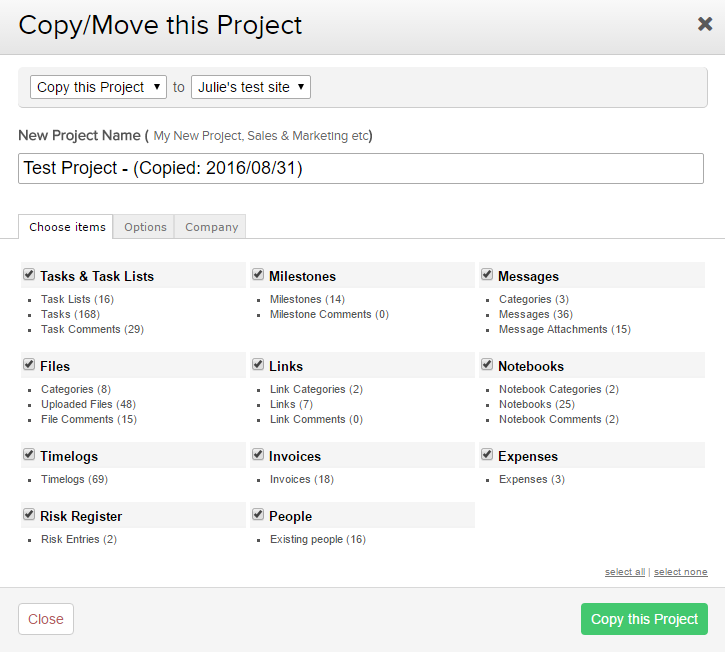

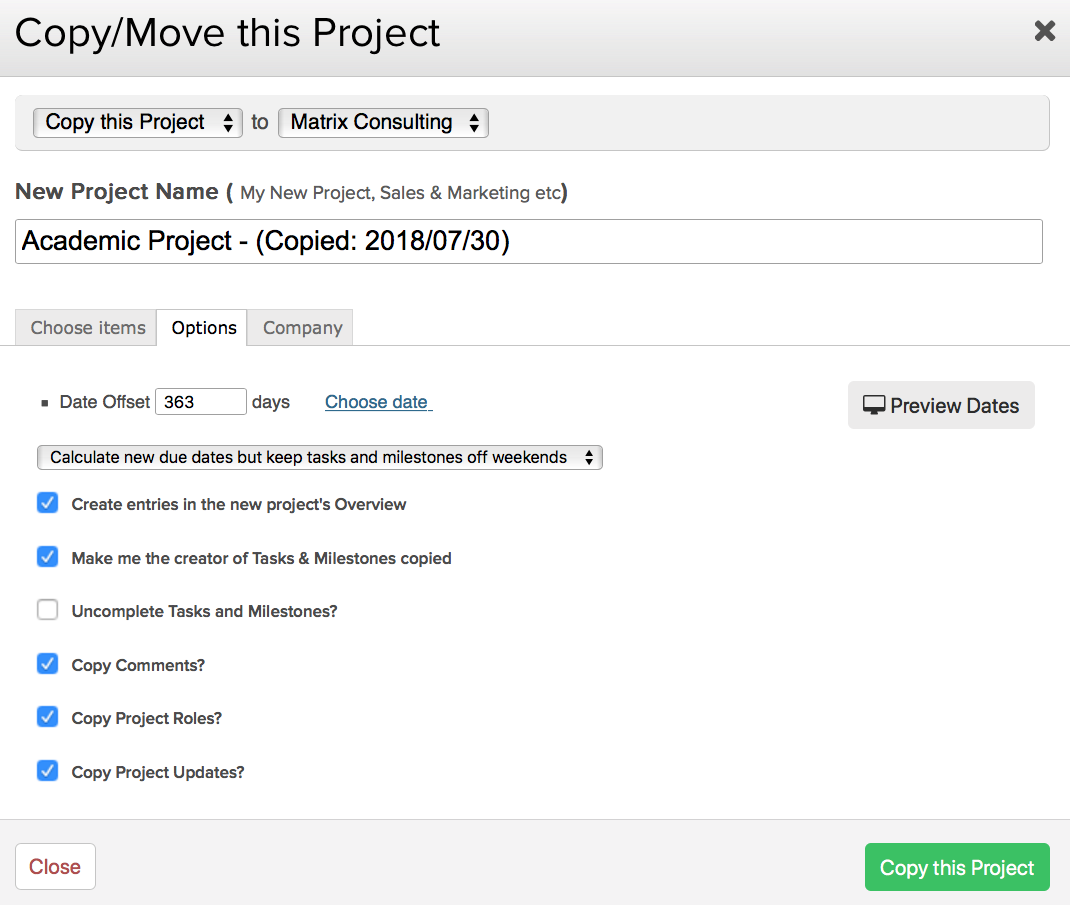

Image Placeholder

Completed tasks can be copied with their completed status, or marked as active again.

Company

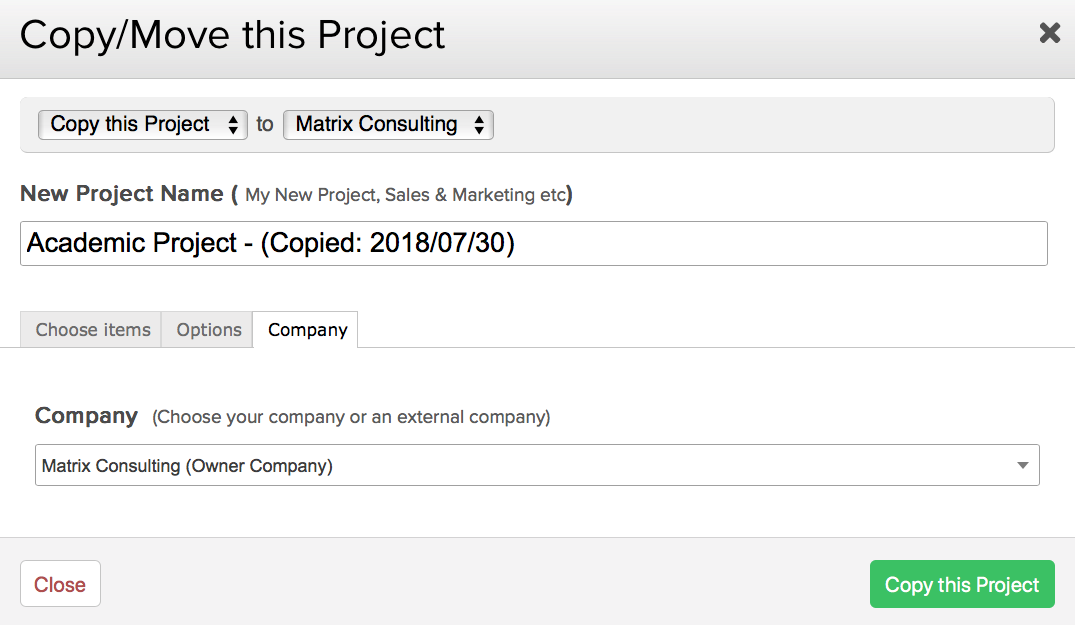

In the company tab, you can choose to associate the copy of the project to a different company than the original project.

Image Placeholder

Excluding weekends

When copying a project, you can choose to exclude weekends by selecting Calculate new dates but keep tasks and milestones off weekends in the Options tab of the copy modal.

Image Placeholder

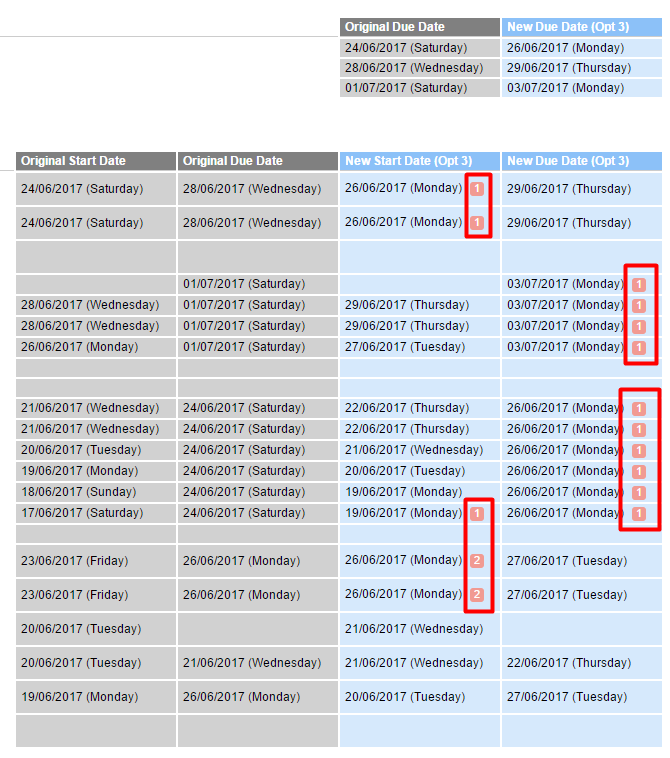

By clicking  Preview Dates, you can see the number of days any affected dates will move forward based on your choice to avoid dates landing on a weekend day (denoted in red).

Image Placeholder

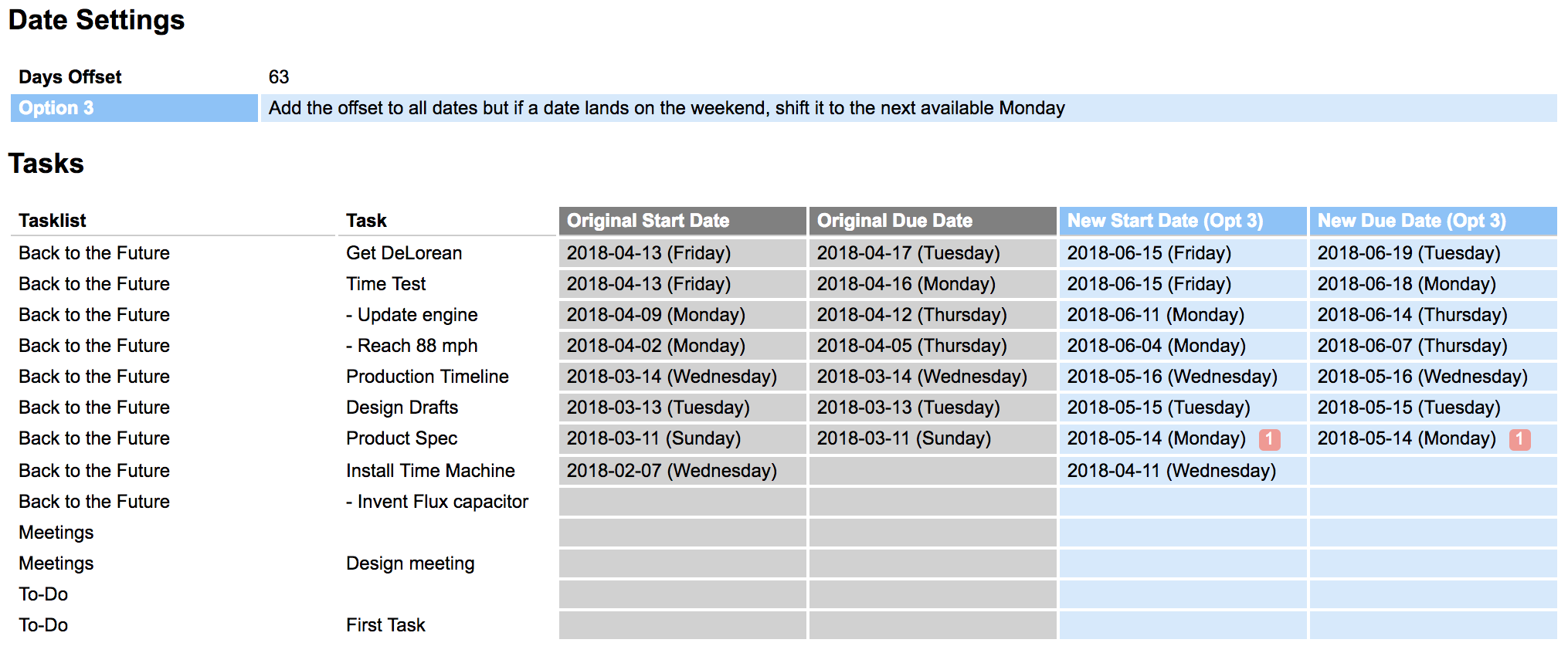

As an example, task A starts on Day 1 and is due on day 13. Add the task on a Monday (day 1).

  • Include weekends:
    • Calendar: Mon | Tue | Weds | Thurs | Fri | Sat | Sun | Mon etc.
    • Result: Start Monday (day 1), due Saturday (day 13)
  • Don't include Saturdays and Sundays (they are not included in the number of day count):
    • Calendar: Mon | Tue | Weds | Thurs | Fri | Mon etc.
    • Result: Start Monday (day1), due Wednesday (day 17)
      • Saturday and Sunday have not been included in this calendar count.
For more information, see: Moving or Copying Projects Between Sites
